Recently Completed

Eagle View Elementary School

This is a brand new elementary school planned for a capacity of 800 students. The school is being constructed on Eagle View Blvd in Antioch. This school will be designed to achieve LEED Silver accreditation once completed.

 Eagle View Elementary School

Project details

Mayor
(upon funding) Karl F. Dean
(current) Megan Barry
Council
District District 32 - Jacobia Dowell email
School board
District District 6 - Tyese Hunter email
Location
1470 Eagle View Boulevard map it
Total project square footage
99,615 SF
Allocated funding
$19,000,000
Architect
EOA Architects
Contractor
Orion Building Corporation
Anticipated completion date
July 2018

Construction Updates

Updates will be posted on a monthly basis while the project is under construction.


Update: (11/1/2018)

Please visit the following link to enjoy a video of the gran opening ceremony for Eagle View Elementary School.

https://www.youtube.com/watch?v=VQN95ohMK04


Update: (8/1/2018)

Eagle View Elementary is compete.  Please visit the following link to see a video of the construction progress and first day of school.

https://www.youtube.com/watch?v=DIbMdf65oIY


Update: (7/1/2018)

Ceiling grid is complete. Painting is complete. MPE trim-out is complete. Flooring work is 90% complete. Placement of topsoil is 95% complete.  Exterior sidewalks are 90% complete.  Casework and cubbies are 80% complete.  Anticipated work to be performed over the next month includes the following:

  • Paving to be complete

  • Site work to be complete

  • Building to be complete


Update: (6/1/2018)

Ceiling grid is 90% complete. Painting is 90% complete. HVAC for classrooms are complete on the first and second floors. VCT flooring is 75% complete. Placement of topsoil is 90% complete.  Exterior sidewalks are 60% complete.  Anticipated work to be performed over the next month includes the following:

  • HVAC to be complete

  • VCT work to be complete

  • Painting to be complete

  • Cubbies and case work to be complete

  • Paving to begin


Update: (5/1/2018)

Ceiling grid is nearly complete. Paint is continuing on second floor. Window installation is complete. HVAC for classrooms are complete on the first and second floors. VCT flooring is underway. Placement of topsoil is progressing.  Exterior sidewalk installation has begun.  Anticipated work to be performed over the next month includes the following:

  • HVAC to be complete

  • VCT work to continue

  • Painting to continue

  • Cubbies and case work to continue

  • Paving to begin


Update: (4/1/2018)

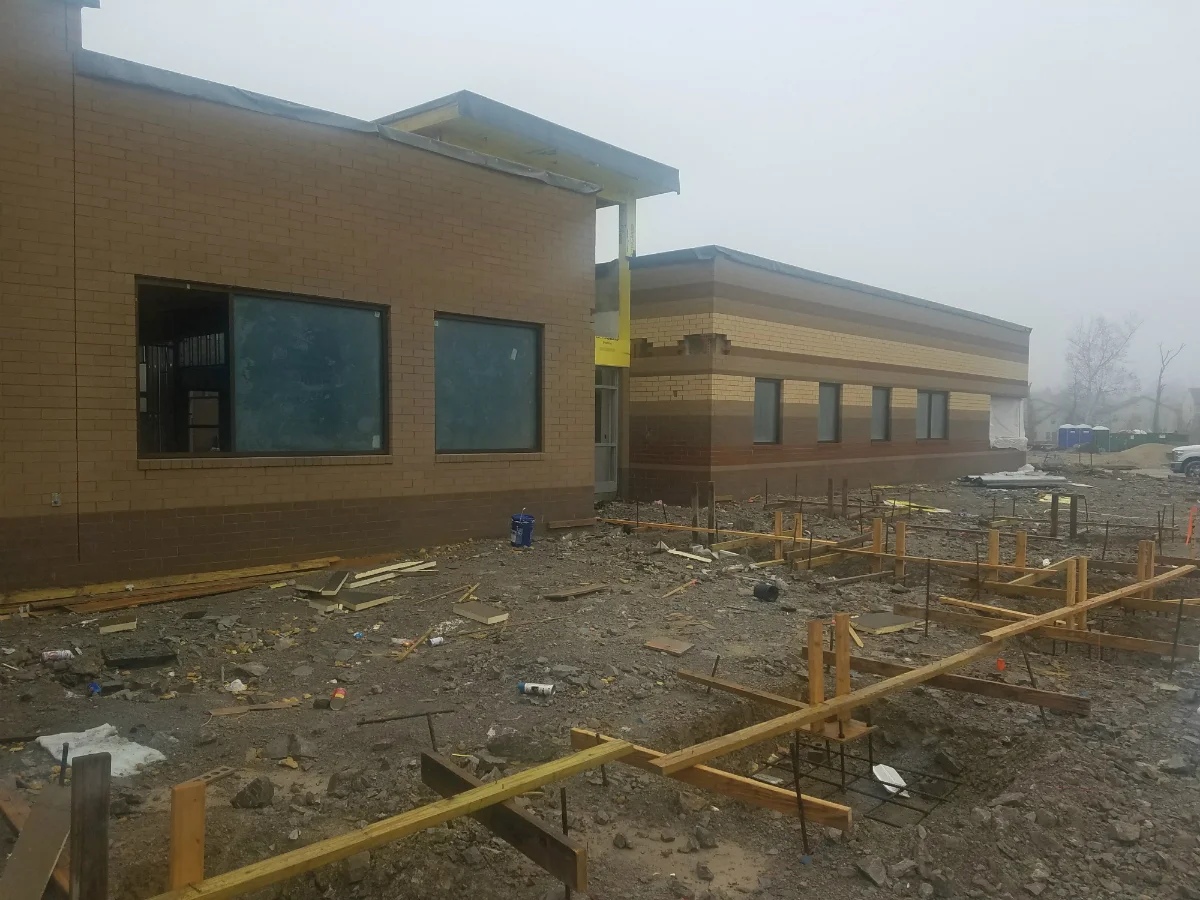

Exterior doors are complete. Ceiling grid is being installed. Paint is continuing on second floor. Window installation is nearly complete. HVAC for classrooms are beginning to be turned on in the second floor.  Anticipated work to be performed over the next month includes the following:

  • 1st floor classroom HVAC to be complete

  • All tile work

  • Painting to continue.

  • Cubbies and case work for first floor


Update: (3/21/2018)

Drywall work in Administration is complete. Ceiling grid is being installed. Exterior doors are beginning to be set. Paint block fill continues. Window installation is nearly complete. HVAC for classrooms are beginning to be turned on.  Anticipated work to be performed over the next month includes the following:

  • 1st floor classroom HVAC to be complete

  • Exterior doors to be complete

  • Painting to continue.

  • Windows to be complete


Update: (2/1/2018)

Roofing is complete. Paint block fill continues. Window installation is nearly complete. Drywall is continuing. MEP overhead work is complete.  Some HVAC has been turned on. Anticipated work to be performed over the next month includes the following:

  • Drywall Work to be complete

  • Painting to continue.

  • Windows to be complete


Update: (1/1/2018)

Overhead MPE work is nearly complete. Roofing work is nearing completion.  Paint block fill continues. Window installation is nearly complete.  Masonry work is complete.  Drywall work has begun.  Anticipated work to be performed over the next month includes the following:

  • Roofing work to be complete.

  • Overhead MEP to be complete

  • Drywall Work to be complete

  • Painting to continue.

  • Windows to be complete


Update: (12/1/2017)

Overhead MPE work is 85% complete. Roofing work is nearing completion.  Paint block fill continues. Window installation is 80% complete.  Anticipated work to be performed over the next month includes the following:

  • Roofing work to be complete.

  • Overhead MEP to continue

  • Drywall Work to begin

  • Masonry work to be complete

  • Block fill Painting to continue

  • Windows to be complete


Update: (11/1/2017)

Masonry work is complete.  Site Electrical is complete.  Overhead MPE work is ongoing. Site utility work is complete.  Roofing work is ongoing.  Paint block fill continues. Window frame installation has begun.  Anticipated work to be performed over the next month includes the following:

  • Roofing work to continue.

  • Overhead MEP to continue

  • Drywall Work to begin

  • Masonry work to continue

  • Block fill Painting to continue

  • Window Frames to continue


Update: (10/1/2017)

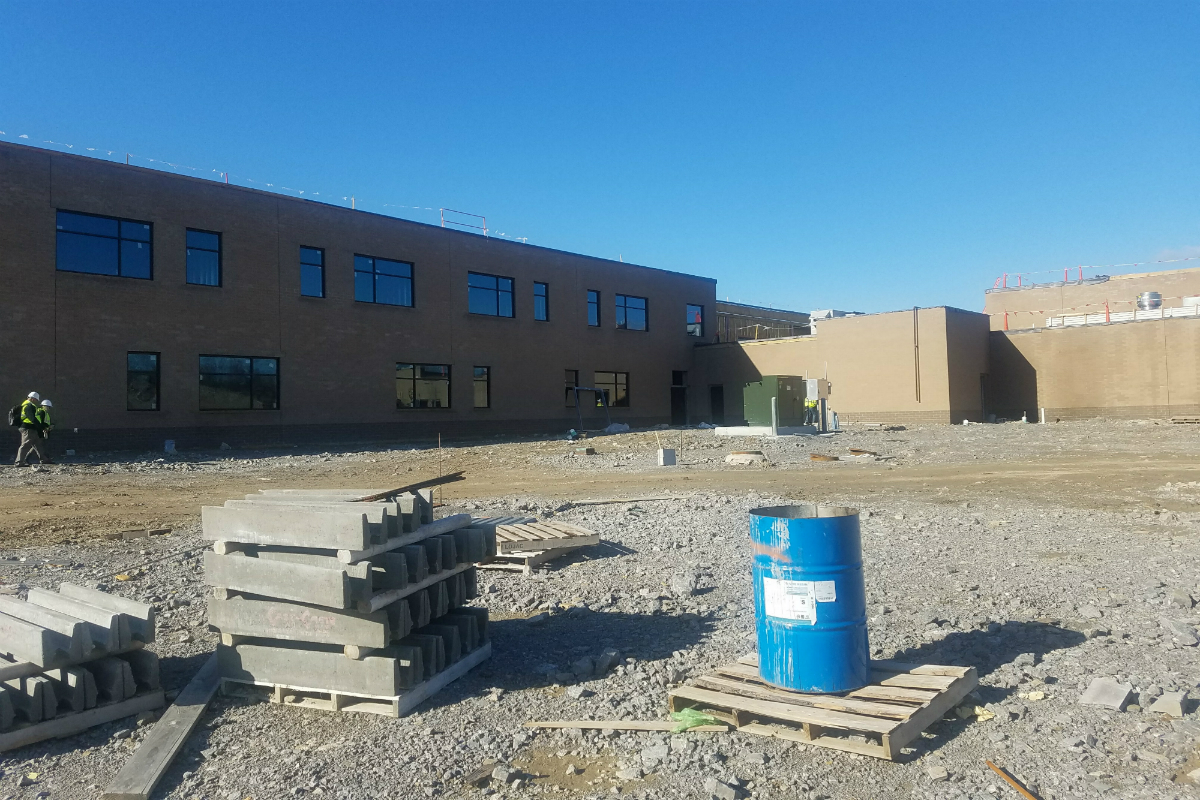

Masonry work is nearly complete.  Precast planks are complete.  Underground MEP is complete.  Overhead MPE work is ongoing. Site utility work is complete.  Roofing work has begun.  Paint block fill has begun. Anticipated work to be performed over the next month includes the following:

  • Roofing work to continue.

  • Overhead MEP to continue

  • Masonry work to continue

  • Electrical transformer to be set.

  • Block fill Painting to continue


Update: (8/1/2017)

Building footings are complete.  Masonry work to first floor bearing is complete.  Precast planks are 60% complete.  Underground MEP is complete.  Overhead MPE work is underway. Site utility work is complete.  Anticipated work to be performed over the next month includes the following:

  • Roofing work to begin.

  • Overhead MEP to continue

  • Masonry work to continue

  • Precast Plank installation to be completed.


Update: (06/01/2017)

Building footings are 75% complete.  Masonry work to finish floor elevation complete in section C & D.  Underground MEP is 90% complete.  Site utility work is nearly complete.  Anticipated work to be performed over the next month includes the following:

  • Building footings to continue.

  • Underground MEP to continue

  • Masonry work to continue

  • Precast Plank installation to begin.


Update: (5/1/2017)

Building footings are 60% complete. Masonry work to finish floor elevation is ongoing. Underground MEP is 70% complete. Site utility work is nearly complete. Anticipated work to be performed over the next month includes the following:

  • Building footings to continue.

  • Underground MEP to continue

  • Masonry work to continue


Update: (4/1/2017)

Storm drainage work is complete. Parking lot grading is complete. Building footings have begun. Masonry work to finish floor elevation has begun. Underground MEP has begun. Site utility work is nearly complete. Anticipated work to be performed over the next month includes the following:

  • Building footings to continue.

  • Underground MEP to continue

  • Masonry work to continue


Update: (3/1/2017)

Placement of shot rock fill is complete. The retaining walls are complete. Storm drainage work is nearly complete. Parking lot grading is nearly complete. Survey layout of building is complete. Anticipated work to be performed over the next month includes the following:

  • Site work to continue

  • Storm Drainage work to be completed.

  • Building Permit to be obtained

  • Building footings to begin

  • Underground MEP to begin


Update: (2/1/2017)

Placement of shot rock fill continues. The building pad is complete to sub grade. The large retaining wall is complete and the other walls have begun. Storm drainage structures have been delivered and the installation is 75% complete. Relocation of existing sewer line has been completed. Anticipated work to be performed over the next month includes the following:

  • Site work and placement of site shot rock fill to continue.

  • Retaining wall and storm Drainage work to be completed.

  • Building footings to begin

  • Underground MEP to begin


Update: (1/1/2017)

Placement of shot rock fill continues. Approximately 70% of the building pad is to sub grade. Retaining walls are approximately 50% complete. Storm drainage structures have been delivered and the installation has begun. Anticipated work to be performed over the next month includes the following:

  • Placement of site shot rock fill to continue.

  • Retaining wall work to continue.

  • Storm Drainage work to continue

  • Building Pad to be completed


Update: (12/1/2016)

Placement of shot rock fill is underway. Approximately 30% of the building pad is to sub grade. Retaining wall material has been delivered to begin. Anticipated work to be performed over the next month includes the following:

  • Site work to continue

  • Placement of site shot rock fill to continue.

  • Retaining wall work to continue.

  • Storm Drainage work to begin


Update: (11/1/2016)

The site work for this project is underway. Erosion control is in place and the site is cleared. Anticipated work to be performed over the next month includes the following:

  • Site work to continue

  • Placement of site shot rock fill to continue.

  • Retaining wall to begin.
