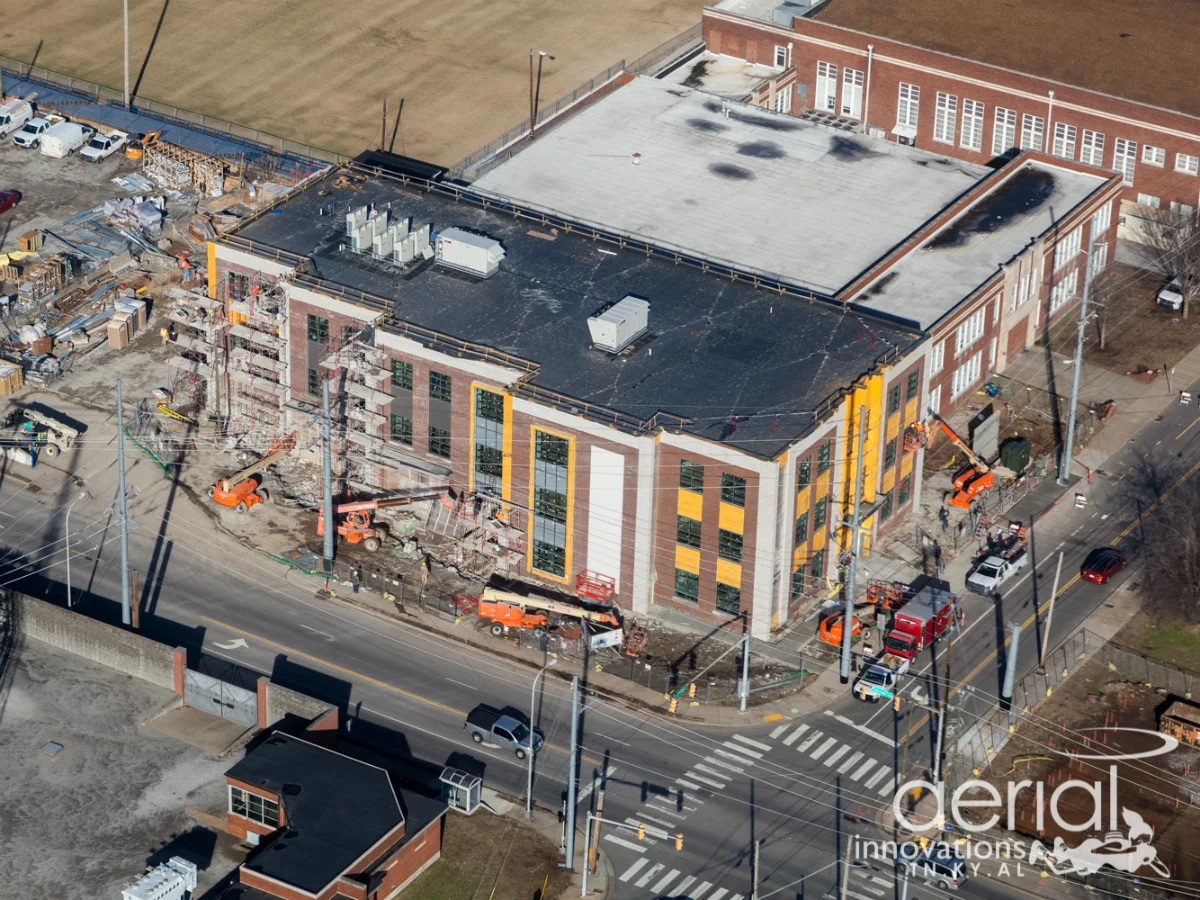

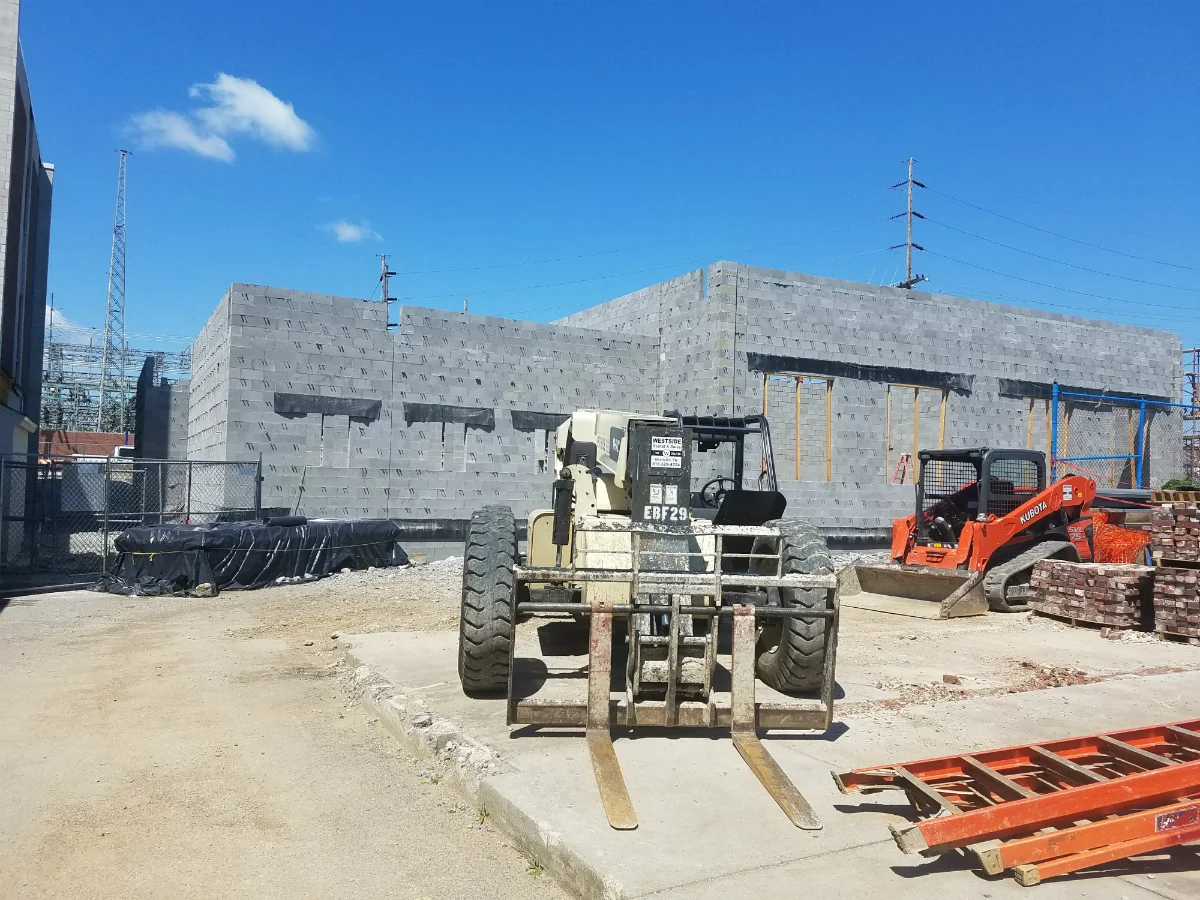

Under construction

Martin Luther King Jr Magnet High School

This is phase II of the renovation and expansion of MLK.  The project will include expansion of the cafeteria, kitchen, and adjacent commons area.  The athletic locker rooms will be expanded and the music program will be provided a new home.  The project will also renovate most of the existing school to upgrade the existing HVAC, plumbing, and electrical systems.

Martin Luther King Jr Magnet High School

Project details

Mayor
(upon funding) Karl F. Dean
(current) Megan Barry
Council
District District 19 - (upon funding) Erica Gilmore
(current) Freddie O'Connell (email) email
School board
District District 5 - (upon funding) Elissa Kim
(current) Christiane Buggs (email) email
Location
613 17th Avenue North map it
Total project square footage
203,731 SF
Allocated funding
$30,000,000
Architect
Bauer Askew Architecture
Contractor
American Constructors
Anticipated completion date
December 2018

Construction Updates

Updates will be posted on a monthly basis while the project is under construction.


Update: (8/1/2018)

Phase 4 Auditorium is 95% complete.  Phase 5 PE Locker Rooms are 95% complete.  Phase 6 is 90% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 4 Auditorium Projector and screen to be installed.
  • Phase 4 Auditorium Lighting and Sound to be complete.
  • Phase 5 PE Locker Room work to be complete.
  • Phase 6 to be complete.
  • Small Gym HVAC to be complete.

Update: (7/1/2018)

Phase 3 Kitchen Equipment has been set.  Phase 3 Cafeteria flooring is complete.  Phase 4 Auditorium Theatrical Sound and Lighting is 60% complete.  Phase 4 Auditorium finishes are 75% complete.  Soccer stadium concession stand work is complete.  Phase 5 PE Locker Room MPE overhead rough in is complete.  Phase 5 PE Locker Room masonry work is complete.  Phase 5 PE Locker Room tile is complete.  Phase 5 MPE trim out is 50% complete.  Phase 6 Masonry work is complete.  Phase 6 MPE Overhead rough in is 40% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 4 Auditorium Theatrical Sound and Lighting to be complete.
  • Phase 4 Auditorium Seating to be complete.
  • Phase 5 PE Locker Room work to be complete.
  • Phase 6 to be complete.

Update: (61/2018)

Phase 3 Kitchen quarry tile is complete.  Phase 3 Cafeteria flooring is 75% complete.  Phase 4 Auditorium ceiling is complete.  Phase 4 Auditorium MEP overhead rough in is complete.  Soccer stadium stands extension work is complete.  Soccer stadium concession stand work is 80% complete.  Phase 5 PE Locker Room overhead rough in is 75% complete.  Phase 5 PE Locker Room masonry work is 90% complete.  Phase 6 Demolition has begun.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria Finishes to be complete.
  • Phase 4 Auditorium MEP rough in to continue.
  • Soccer Field Concession Stand work to be complete.
  • Phase 5 PE Locker Room work to continue
  • Phase 6 Demolition to continue

Update: (5/1/2018)

Phase 3 Kitchen and Cafeteria Cooler and Freezer is set.  Phase 3 Kitchen and Cafeteria drywall work is complete.  Phase 3 MEP overhead rough in is complete.  Phase 4 Auditorium demo is complete.  Phase 4 Auditorium concrete work is complete.  Phase 4 Auditorium MEP overhead rough 75% complete.  Soccer stadium stands extension work is complete.  Soccer stadium concession stand work is 20% complete.  Phase 5 PE Locker Room underground rough in is complete.  Phase 5 PE Locker Room masonry work has begun.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria Quarry Tile to be complete.
  • Phase 3 New Kitchen and Cafeteria Finishes to continue.
  • Phase 4 Auditorium MEP rough in to continue.
  • Soccer Field Concession Stand work to continue.
  • Phase 5 PE Locker Room work to continue

Update: (4/1/2018)

Phase 3 Kitchen and Cafeteria Cooler and Freezer is set.  Phase 3 Kitchen and Cafeteria drywall work is complete.  Phase 3 MEP overhead rough in is complete.  Phase 4 Auditorium demo is complete.  Phase 4 Auditorium concrete work is complete.  Phase 4 Auditorium MEP overhead rough in is progressing.  Site work at the soccer field is complete.  Soccer stadium stands extension work continues.  Soccer stadium concession stand work has begun.  Phase 5 PE Locker Room demolition is complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria Quarry Tile to begin.
  • Phase 3 New Kitchen and Cafeteria Finishes to continue.
  • Phase 4 Auditorium MEP rough in to continue.
  • Soccer Field Concession Stand work to continue.
  • Phase 5 PE Locker Room work to begin.

Update: (3/1/2018)

Phase 3 Kitchen and Cafeteria set HVAC units are complete.  Phase 3 Kitchen and Cafeteria drywall work is complete.  Phase 3 MEP overhead rough in is nearly complete.  Phase 4 Auditorium demo is complete. Phase 4 Auditorium MEP rough in has begun.  Phase 4 Auditorium concrete work is progressing.  Phase 4 Auditorium MEP overhead rough in is progressing.  Site work at the soccer field is complete.  Soccer stadium stands extension has begun.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria Set Cooler and Freezer to begin.
  • Phase 3 New Kitchen and Cafeteria Quarry Tile to begin.
  • Phase 3 New Kitchen and Cafeteria Finishes to begin.
  • Phase 4 Auditorium concrete work to be complete.
  • Phase 4 Auditorium MEP rough in to be complete.
  • Soccer Field work to be continue.

Update: (2/1/2018)

Phase 3 Kitchen and Cafeteria underground rough in is complete.  Phase 3 Kitchen and Cafeteria drywall work is complete.  Phase 3 MEP overhead rough in is 80% complete.  Phase 4 Auditorium demo is complete. Phase 4 Auditorium MEP rough in has begun.  Site work at the soccer field is 90% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria MEP Overhead Rough in to be complete.
  • Phase 3 New Kitchen and Cafeteria
  • Phase 3 New Kitchen and Cafeteria Finishes to begin.
  • Phase 4 Auditorium Lighting and Sound to be bid.
  • Phase 4 Auditorium MEP rough in to continue.
  • Soccer Field work to be complete

Update: (1/1/2018)

Connector corridor is complete.  Phase 3 Kitchen and Cafeteria underground rough in is nearly complete.  Phase 3 Kitchen and Cafeteria drywall work is nearly complete.  Phase 3 MEP overhead rough in has begun.  Phase 4 Auditorium demo has begun.   Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria MEP Overhead Rough in to be complete.
  • Phase 3 New Kitchen and Cafeteria Drywall work to be complete.
  • Phase 3 New Kitchen and Cafeteria Finishes to begin.
  • Phase 4 Auditorium demo to begin.

Update: (12/1/2017)

Connector corridor roof work is complete.  Connector corridor finishes are 50% complete.    Phase 3 New Kitchen and Cafeteria Demo is complete.  Phase 3 Kitchen and Cafeteria underground rough in is 75% complete.  Phase 3 Kitchen and Cafeteria drywall work has begun.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria MEP Rough in to be complete.
  • Phase 3 New Kitchen and Cafeteria Drywall work to continue.
  • Connector Corridor Finish work to be complete.
  • Phase 4 Auditorium demo to begin.

Update: (11/1/2017)

Phase 2A and 2B is complete and was occupied at Fall Break.  Connector corridor steel work is complete.  Connector corridor masonry work is complete.  Connector Corridor finish work has begun.  Phase 3 New Kitchen and Cafeteria Demo has begun.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 New Kitchen and Cafeteria Demo to be complete.
  • Phase 3 New Kitchen and Cafeteria MEP Rough in to begin.
  • Phase 3 New Kitchen and Cafeteria Drywall work to begin.
  • Connector Corridor Finish work to be complete.
  • Connector Corridor Finish MEP Trim Out to be complete.

Update: (10/1/2017)

Phase 2B 1st floor is complete.  Phase 2A brick work is complete.  Phase 2A MEP trim out is 95% complete.  Phase 2B 2nd and 3rd floor MEP trim out is 90% complete. Phase 2A Finishes are 90% complete.  Connector corridor steel work has begun.  Connector corridor masonry work is 95% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 2A to be complete and school to occupy during fall break.
  • Phase 2B to be complete and school to occupy during fall break.
  • Phase 3 New Kitchen and Cafeteria Demo to begin.
  • Connector Corridor Steel work to be complete.
  • Connector Corridor Roofing to begin.
  • Connector Corridor Masonry work to be complete.

Update: (9/1/2017)

Phase 2B 1st floor is complete.  Phase 2A brick work is near completion.  Phase 2A MEP rough in is complete.  Phase 2B 2nd and 3rd floor MEP rough in is 90% complete. Phase 2A Roofing work is complete.  Connector corridor slab is complete.  Connector corridor masonry work is 90% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 2A brick work to be complete.
  • Phase 2A MEP rough in to be complete.
  • Phase 2A Finishes to begin.
  • Phase 2B 2nd & 3rd MEP Trim out to begin.
  • Phase 2B 2nd & 3rd Finishes to begin.
  • Connector Corridor Steel work to begin.

Update: (8/1/2017)

Phase 2B 1st floor finishes near completion.  Phase 2A case work for 1st floor is complete.  Phase 2A brick work has begun.  Phase 2A block work is complete.  Phase 2B 2nd and 3rd floor MEP rough in is 70% complete. Phase 2A Roofing work is 90% complete.  Connector corridor foundations are complete.  Connector corridor masonry work is 70% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 2A brick work to continue.
  • Phase 2A MEP rough in to continue.
  • Phase 2A Roofing work to be completed.
  • Phase 2B 2nd & 3rd floor wall framing rough in to be completed.
  • Phase 2B 2nd & 3rd floor overhead MEP rough in to begin.
  • Connector Corridor Steel work to begin.

Update: (6/1/2017)

Phase 2B wall framing continues on the 2nd and 3rd floor in the 1936 wing.  Phase 2A concrete slab is complete.  Phase 2A block work is nearly complete.  Phase 2B demolition of the 1st floor classrooms and admin area has begun.  Soccer field concession stand has been demolished.  Anticipated work to be performed over the next month includes the following:

  • Phase 2A block walls to be completed.
  • Phase 2A steel work to be completed.
  • Phase 2A brick work to begin.
  • Phase 2A MEP rough in to continue.
  • Phase 2B wall framing rough in to be completed.
  • Phase 2B underground plumbing rough in to be completed.
  • Phase 2B in wall MEP rough in to be completed.
  • Phase 2B overhead MEP rough in to begin.

Update: (5/1/2017)

Phase 2A footings are complete. Phase 2B wall framing has begun in the 2nd and 3rd floor in the 1936. Phase 2A concrete slab is 50% complete. Phase 2A masonry work continues. Soccer field concession stand has been demolished. Anticipated work to be performed over the next month includes the following:

  • Phase 2A concrete slab to be completed
  • Phase 2A block walls to continue
  • Phase 2A MEP in wall rough in to continue

Update: (4/1/2017)

Phase 1 Addition is complete. Phase 2A footings are underway and 80% complete. Phase 2B demolition of the 2nd and 3rd floor in the 1936 wing has begun. Phase 2A underground MEP has begun. Anticipated work to be performed over the next month includes the following:

  • Phase 2A footings to be complete.
  • Phase 2A underground MEP to be complete.
  • Phase 2A concrete slab to begin
  • Phase 2A block walls to begin

Update: (3/1/2017)

Phase 1 Addition Electrical and Mechanical trim out is complete. Phase 1 Flooring is nearly complete.   Aluminum Storefront installation is complete. Metal Panel installation is nearly complete. Phase 2A sitework has begun. Anticipated work to be performed over the next month includes the following:

  • Phase 1 classrooms to be turned over at spring break.
  • Phase 2A site work to continue
  • Phase 2A footings to begin
  • Demolition of Phase 2B renovation to begin

Update: (2/1/2017)

Drywall work is complete. Masonry exterior work is complete. Electrical and Mechanical trimout is near completion. Roofing work is complete. Flooring is 90% complete.   Aluminum Storefront installation is 95% complete. Metal Panel installation is 95% complete. Phase 2A sitework has begun. Anticipated work to be performed over the next month includes the following:

  • Phase 1 classrooms to be turned over at spring break.
  • Phase 2A site work to continue and footings to begin
  • Bid of remaining trades for Phase 2A scheduled for 2/9/17
  • Bid of Phase 2B renovation to begin

Update: (1/1/2017)

Masonry work is still underway. Electrical and Mechanical trimout is in progress. Roofing work is nearly complete. Flooring on 3rd and 2nd floor is complete. Aluminum Storefront exterior installation is 80% complete. Metal Panel installation has begun. Concrete slab in internet café is complete. Anticipated work to be performed over the next month includes the following:

  • Electrical and Mechanical trim out to be completed.
  • Aluminum Storefront to be completed.
  • Flooring to be completed.
  • Phase 2A site work to begin

Update: (12/1/2016)

Drywall hanging is complete and finishing is underway on 2nd and 3rd floor. Masonry exterior work is still underway. Electrical and Mechanical trimout is in progress. Roofing work is nearly complete. Anticipated work to be performed over the next month includes the following:

  • Concrete slab for the Internet Café to be completed.
  • Electrical and Mechanical trim out to be completed.
  • Aluminum Storefront framing to be completed.
  • Flooring to be completed.
  • Phase 2A site work to begin.

Update: (11/1/2016)

Metal Stud Framing is complete. Steel erection is underway for the internet cafe. Masonry exterior work has begun. Electrical and Mechanical rough in is in progress. Roofing work is nearly complete. Drywall work on the 3rd and 2nd floor has begun.   Anticipated work to be performed over the next month includes the following:

  • Drywall Hanging and Finish to be completed.
  • Concrete slab for the Internet Café to be completed.
  • Electrical and Mechanical rough in to be completed.
  • Aluminum Storefront framing to begin installation.

Update: (10/1/2016)

Elevated concrete slabs are complete. Steel erection is complete for the main building. Metal stud interior framing is complete. Electrical and Mechanical overhead and in wall rough in underway. Roofing work is underway. Anticipated work to be performed over the next month includes the following:

  • Structural steel erection for Internet Cafe.
  • Metal stud framing to be completed.
  • Concrete slab for the Internet Café to be completed.
  • Electrical and Mechanical rough in to be completed.

Update: (9/1/2016)

Elevated concrete slabs are nearing completion. Steel erection is nearing completion. Handrails for metal stairs have been completed. Metal stud framing is underway. Electrical and Mechanical overhead and in wall rough in has begun. Anticipated work to be performed over the next month includes the following:

  • Structural steel erection will be completed.
  • Metal stud framing to continue.
  • Electrical and Mechanical rough in to continue.
  • Masonry veneer work to begin.

Update: (8/1/2016)

Concrete slab on grade is nearing completion. Steel erection is nearing completion. The elevated slab on the 2nd floor has been placed. The elevated slab on the 3rd floor is underway. Anticipated work to be performed over the next month includes the following:

  • Elevated concrete slabs for 3rd will be completed
  • Structural steel erection will be completed.
  • Metal stud framing to begin.
  • Handrails for metal stairs to be installed
  • Electrical and Mechanical rough in to begin

Update: (7/1/2016)

Concrete footings are complete. Installation of poured concrete stem walls are complete. Concrete block for stairwells and elevator shaft are complete. Under slab rough in for plumbing and electrical has been completed. First Section of concrete slab on grade has been placed. Steel erection has begun.   Anticipated work to be performed over the next month includes the following:

  • Elevated concrete slabs for second and third floors.
  • Structural steel erection will continue.
  • Metal stud framing to begin

Update: (6/1/2016)

Concrete footings are nearly complete. Installation of poured concrete stem walls is complete. Concrete block for stairwells are nearly complete. Elevator pit is complete. Masonry walls for elevator pit are in progress. Anticipated work to be performed over the next month includes the following:

  • Release all trade packages for Phase 1A and B with value engineered options.
  • Concrete slab for first floor to be poured in sections.
  • Structural steel erection will begin

Update: (5/1/2016)

Concrete footings have begun. Bidding of Drywall package for Phase 1A and B is complete. Structural Steel shop drawings have been approved and steel is to be delivered to the jobsite next month. Anticipated work to be performed over the next month includes the following:

  •  Release all trade packages for Phase 1A and B with value engineered options.
  • Concrete footings for new building to continue.
  • Concrete elevator pit to be poured
  • Begin structural steel erection

Update: (4/01/2016)

Electrical underground for temporary and permanent power feed is complete. Preparation of Phase 1A and B building pad is ongoing. Anticipated work to be performed over the next month includes the following:

  • Continued site work.
  • Construction of off-site temporary parking lot for staff and students and contractor staging area.
  • Shop fabrication of Structural Steel for building structure.
  • Foundations for building

Update: (3/01/2016)

Electrical underground for power is underway. Demolition of the existing concrete and asphalt parking in anticipation of building pad work. Anticipated work to be performed over the next month includes the following:

  • Continued site work.
  • Construction of off-site temporary parking lot for staff and students and contractor staging area.
  • Fabrication of reinforcing for concrete slab and footing.
  • Shop fabrication of Structural Steel for building structure.
  • Preparation and mobilization of concrete work for transformer pad and protection wall.

Update: (2/01/2016)

Electrical underground work will start soon. Structural steel installation will start soon. Anticipated work to be performed over the next month includes the following:

  • Commencement of the underground electrical.
  • Bidding of the site civil construction and awarding of the contract.
  • Bidding of the structural package and awarding of the contract.
  • Commencement of the site work.
  • Temporary parking spaces installation

Update: (1/01/2016)

Temporary parking lot is completed with construction office trailer and storage building for construction. ADA ramp and new temporary entrance for student/staff access is completed. Anticipated work to be performed over the next month includes the following:

  • NES has been released to Order new custom power pole.
  • The Transformer required for Temporary/Permanent power will be installed.
  • Electrical site work will commence.
  • Site improvements will begin

Update: (12/01/2015)

Demolition of the Old Moore building has been completed. The temporary parking lot is ready to relocate parking to commence preparation for construction to begin depending upon NES assistance in relocating power poles and feeds, installing new permanent transformer in the next approximately 60 days. Anticipated work to be performed over the next month includes the following:.

  • NES Order new transformer and custom power pole.
  • Commence relocation of power poles and feeders after new transformer is received and installed.

Update: (11/1/15)

The Moore building has been demolished. Anticipated work to be performed over the next month includes the following:

  • Preparation for temporary parking lot

Update: (10/1/15)

Abatement of the Moore building is complete.  The building awaits utility removal before the building can be demolished. Anticipated work to be performed over the next month includes the following:

  • Begin demolition of the Moore Building
  • Begin construction of new student parking lot

Update: (9/1/15)

The construction manager is on board and design is complete on Phase 1. Abatement of the Moore Building is ongoing. Anticipated work to be performed over the next month includes the following:

  • Completion of abatement of Moore Building
  • Begin demolition of the Moore Building

Update: (8/1/2015)

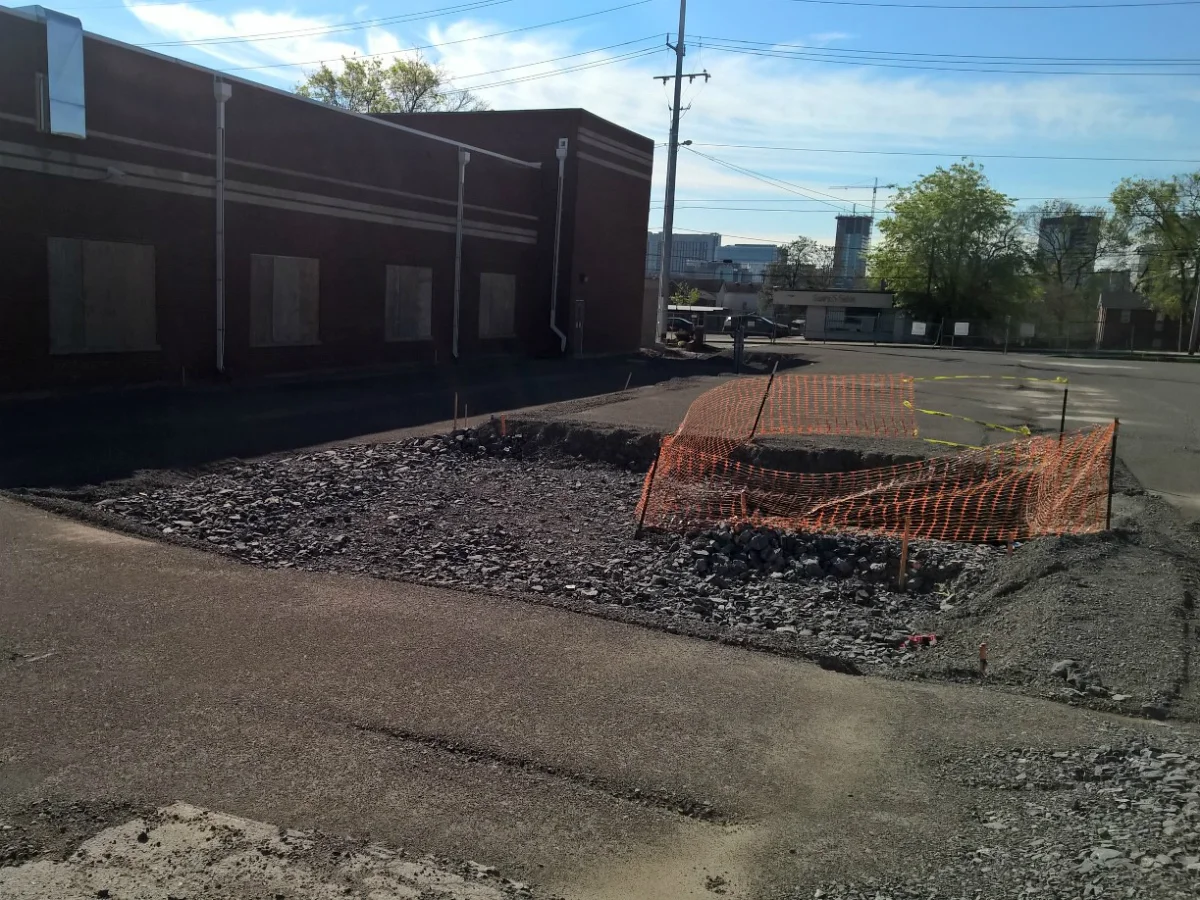

The contract has been awarded and site set up and water quality structures will be installed this month. Anticipated work to be performed over the next month includes the following:

  • Begin site work

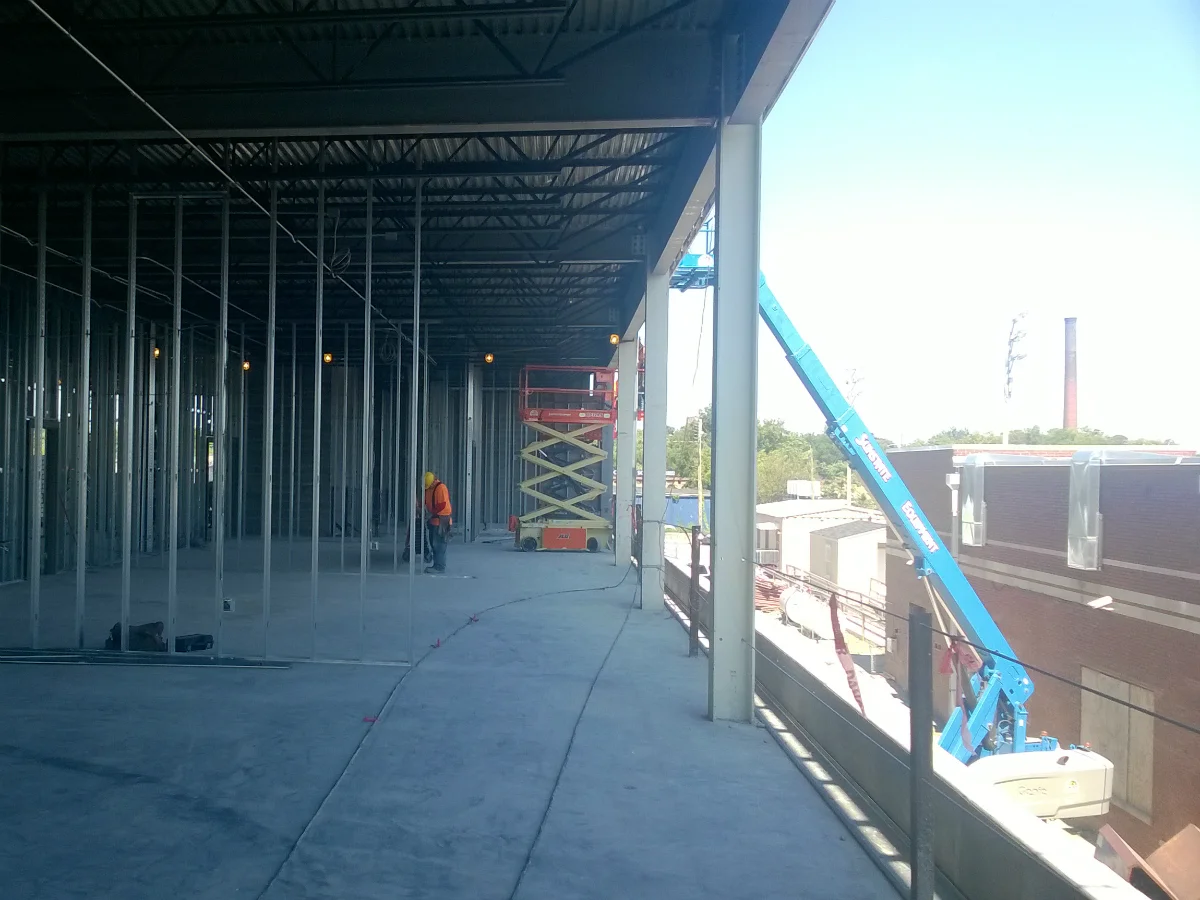

  • Begin building layout.
