Recently Completed

Overton High School

This project is a complete facility renovation and classroom addition.  The building will be modernized and receive new windows, HVAC system, and lighting.  The cafeteria will be expanded along with the library and administrative areas.  The construction will be phased.

Overton High School

Project details

Mayor
(upon funding) Karl F. Dean
(current) Megan Barry
Council
District 34 - (upon funding) Carter Todd
(current) Angie Henderson email
School board
District 2 - Jo Ann Brannon email
Location
4820 Franklin Pike map it
Total project square footage
298,185 SF
Allocated funding
$40,000,000
Architect
TM Partners
Contractor
American Constructors
Anticipated completion date
July 2018

Construction Update

Updates will be posted on a monthly basis while the project is under construction.


Update: (8-01-2018)

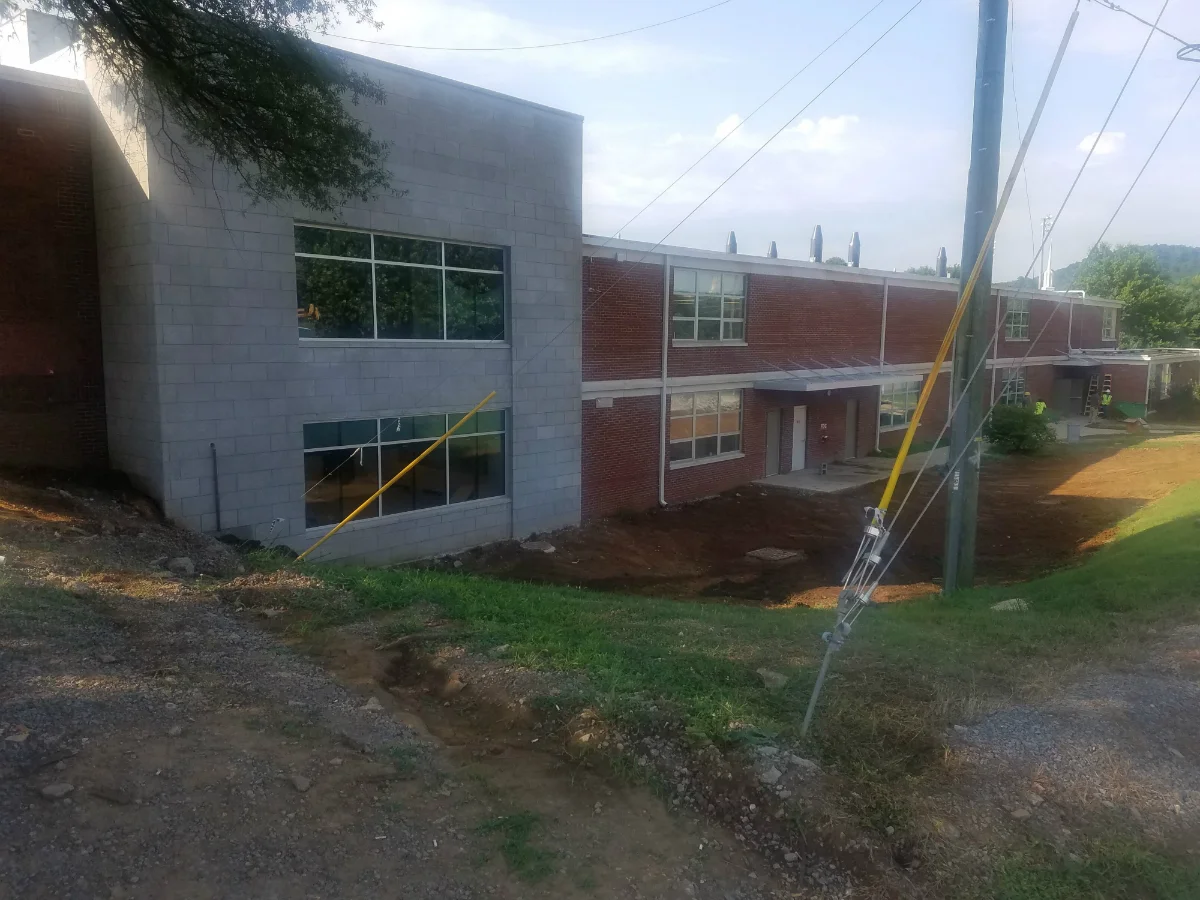

Construction at Overton High School is complete.

Main Entry.jpg

Update: (7-01-2018)

Phase 5 Classroom addition finishes are 90% complete. Phase 5 Classroom addition MEP trim out is 75% complete. Phase 6 Demolition Is complete.  Phase 6 masonry work is complete.  Phase 6 MEP rough is 75% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 5 Classroom addition to be complete.
  • Phase 6 to be complete.
  • Loop Road topping to be complete.
  • TA Parking Lot to be patched and sealed.

Update: (6-01-2018)

Phase 5 Classroom addition masonry work is complete. Phase 5 Classroom addition MEP rough in is complete. Phase 6 Demolition has begun.  Anticipated work to be performed over the next month includes the following:

  • Phase 5 Classroom addition MEP trim out to be complete.
  • Phase 5 Classroom addition finishes to be complete.
  • Phase 6 Demolition to be complete.
  • Phase 6 MEP Rough in to begin.
  • Phase 6 Masonry work to be complete.

Update: (5-01-2018)

Phase 4 Classroom addition is complete.  Phase 5 Classroom addition roof work is complete.  Phase 5 Classroom addition masonry work is 90% complete. Phase 5 Classroom addition MEP rough in is 75% complete. Phase 5 Courtyard work is complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 5 Classroom addition MEP rough in to be complete.
  • Phase 5 Classroom addition masonry work to be complete.
  • Phase 5 Classroom addition windows to be complete.
  • Phase 5 Classroom addition finishes to begin.

Update: (4-01-2018)

Phase 4 Classroom addition is complete.  Phase 5 Classroom addition roof work is nearly complete.  Phase 5 Classroom addition masonry work is underway. Phase 5 Courtyard site work is underway.  Anticipated work to be performed over the next month includes the following:

  • Phase 5 Classroom addition MEP rough in to begin.
  • Phase 5 Classroom addition masonry work to continue.
  • Phase 5 Classroom addition windows to begin.
  • 2nd interior courtyard to be complete

Update: (3-01-2018)

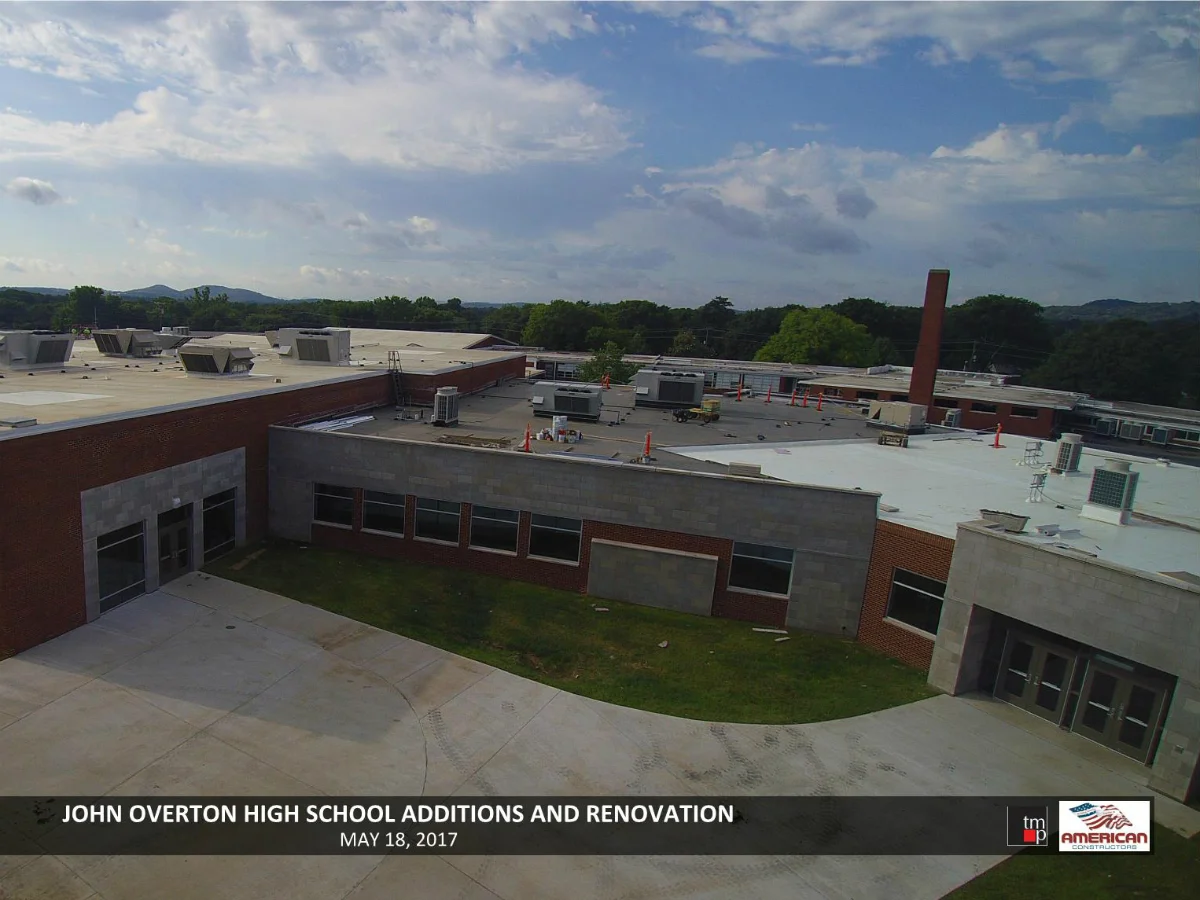

Phase 4 Classroom addition MEP Rough in is complete.  Phase 4 Classroom addition masonry work is nearly complete.  Phase 4 Classroom addition roof work is complete.  Phase 4 Classroom addition finishes have begun.  Phase 5 Classroom addition slab is complete.  Phase 5 Classroom addition masonry work is progressing. Phase 5 Classroom addition steel work is complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 4 Classroom addition masonry to be complete.
  • Phase 4 Classroom addition finishes to begin.
  • Phase 4 Classroom addition to turn over for school use.
  • Phase 5 Classroom addition MEP rough in to begin.
  • Phase 5 Classroom addition masonry work to continue.
  • 2nd interior courtyard to be complete

Update: (2-01-2018)

Phase 4 Classroom addition MEP Rough in is 80% complete.  Phase 4 Classroom addition masonry work is 90% complete.  Phase 4 Classroom addition roof work is 70% complete.  Phase 5 Classroom addition slab is complete.  Phase 5 Classroom addition masonry work has begun. Anticipated work to be performed over the next month includes the following:

  • Phase 4 Classroom addition masonry to be complete.
  • Phase 4 Classroom addition roof to be complete
  • Phase 4 Classroom addition MEP rough in to be complete.
  • Phase 4 Classroom addition finishes to begin.
  • Phase 5 Classroom addition steel work to be complete.
  • Phase 5 Classroom addition masonry work to continue.
  • 2nd interior courtyard to be complete

Update: (1-01-2018)

Phase 4 Classroom addition first and second floor slab is complete.  Phase 4 Classroom addition steel is complete.  Phase 4 Classroom addition masonry work is 50% complete.  Phase 4 Classroom addition roof work has begun.  Phase 5 Classroom addition footings are complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 4 Classroom addition masonry to be continue.
  • Phase 4 Classroom addition roof to be complete
  • Phase 4 Classroom addition MEP rough in to begin.
  • Phase 5 Classroom addition steel work to begin.
  • 2nd interior courtyard to be complete

Update: (12-01-2017)

Phase 4 library connector is complete.  Phase 4 second floor connector has been demolished.  Phase 4 Classroom addition footings are complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 4 Classroom addition slab to be complete.
  • Phase 4 Classroom addition steel to be complete
  • Phase 4 Classroom addition roof to be complete.
  • Phase 4 Classroom addition masonry work to begin.
  • Stadium Renovation track striping to be complete.
  • 2nd interior courtyard to be complete

Update: (11-01-2017)

The 1st Interior Courtyard is complete.  Stadium buildings are complete.  Stadium visitor bleachers installation is complete.  Stadium track is nearly complete.  Phase 4 library connector is nearly complete.  Anticipated work to be performed over the next month includes the following:

  • Library Connector to be complete.
  • Phase 4 second floor connector to be demolished.
  • Phase 4 connector footings to begin.
  • Stadium Renovation track striping to be complete.
  • Loop road to be compete.
  • 2nd interior courtyard to be complete.

Update: (10-01-2017)

Phase 3 Classroom/Admin are complete.  Lockers have been installed.  Stadium buildings are complete.  Stadium visitor bleachers installation is complete.  Stadium storm drainage is complete.  Stadium concrete is 95% complete.  Phase 4 library connector footings are complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 4 Slab to be complete.
  • Phase 4 Masonry to begin.
  • Phase 4 Steel Work to begin.
  • Stadium Renovation track surface to be complete.
  • Loop road to be compete.
  • 1st interior courtyard to be complete.

Construction Update: (08-01-2017)

Phase 3 MPE Trim out is 90% complete.  Phase 3 Casework installation is underway.  Phase 3 flooring is 75% complete.  Stadium buildings are 90% complete.  Stadium visitor bleachers installation has begun.  Stadium storm drainage is complete.  Stadium concrete is 70% complete.  Gym floor refinishing has begun.  Loop road is 90% complete.  Anticipated work to be performed over the next month includes the following:

  • Phase 3 classroom/admin to be complete.
  • Stadium Renovation to be complete.
  • Loop road to be compete.
  • 1st interior courtyard to be complete.
  • Foundation for Library connector corridor to be complete.

Update: 06-01-2017

MPE rough in for the band area is complete.  Block work for band addition is complete.  Brick work for the band additions is 75% complete.  Structural steel for the band additions is complete.  MPE rough in is complete in the locker rooms.  Demolition of the Stadium Renovations is complete.  Stadium sitework has begun.  Demolition of Phase 3 classrooms and admin area has begun.  Demolition in the Gym has begun.  Anticipated work to be performed over the next month includes the following:

  • Demolition of Phase 3 classroom/admin to be complete.
  • Masonry work for band addition to be complete.
  • Interior finishes for locker rooms to begin.
  • Locker room MPE trim out to begin.
  • Underground rough in for Phase 3 to be complete.
  • Interior framing for Phase 3 to be complete.
  • Phase 3 MEP wall rough in to be complete.

Update: 5-01-2017

Interior finishes are nearly complete in old cafeteria space. MPE rough in for the band area is complete. Masonry work for band addition is 90% complete. Structural steel for the band additions has begun. MPE rough in is complete in the locker rooms. Demolition of the Stadium Renovations has begun. Anticipated work to be performed over the next month includes the following:

  • Structural steel for band addition to be complete.
  • Masonry work for band addition to be complete.
  • Interior finishes and MPE trim out for locker rooms to begin.

Update: 4-01-2017

Library is complete. Interior masonry work is complete in old cafeteria space. Mechanical and electrical rough in for old Cafeteria space is complete. MPE rough in for the band area is underway. Masonry work for band addition is nearly complete. Demolition to the varsity locker rooms are complete. MPE rough in is underway in the locker rooms. Anticipated work to be performed over the next month includes the following:

  • Masonry work for band addition to be complete and steel to begin.
  • MPE rough in for locker rooms to be complete.
  • Phase 3 finishes to be complete and MPE trim out to begin.

Update: 3-01-2017

Painting for Library addition is complete. Underground MEP is complete for old Cafeteria renovation. Interior masonry work is 80% complete in old cafeteria space. Mechanical and electrical rough in for old Cafeteria space is underway. Demolition of Band room is complete. Anticipated work to be performed over the next month includes the following:

  • MPE rough in of existing band area to be complete.
  • Masonry and site work at Library addition to be complete.
  • Flooring work in Library to be complete.
  • Masonry and footing for band room addition to continue.

Update: 2-01-2017

Mechanical and electrical rough in, interior/exterior masonry work and drywall work for Library addition is complete. Demolition of existing cafeteria areaand underground MEP for Phase 3 is complete.  Interior masonry an mechanical and electrical rough in for old Cafeteria space is underway. Band room addition site work continues. Anticipated work to be performed over the next month includes the following:

  • Demolition of existing band area to continue.
  • Sitework and masonry work at Library addition to be complete.
  • Masonry and footing for band room addition to continue.

Update: 1-01-2017

Mechanical and electrical rough in and interior/ exterior masonry work are near complete for library addition. Cafeteria is complete. Roofing work is complete. Demolition of existing cafeteria area for Phase 3. Anticipated work to be performed over the next month includes the following:

  • Complete demolition of old kitchen and cafeteria.
  • Begin demolition of existing band area.
  • Masonry work at Library addition to continue.
  • Flooring work in Cafeteria to be completed.
  • Masonry and footing for band room addition to continue.

Update: 12-01-2016

Metal stud framing, mechanical and electrical rough in and interior/exterior masonry work are in progress for library addition.  Structural Steel erection is complete for the Library addition. The kitchen is complete. Anticipated work to be performed over the next month includes the following:

  • Complete Roofing for Library addition.
  • Set Library HVAC units.
  • Masonry work at Library addition to continue.
  • Flooring work in Cafeteria to be completed.
  • Mechanical and Electrical trim out to be completed for Cafeteria

Update: 11-01-2016

The library addition and cafeteria renovation is underway. Metal stud framing, mechanical and electrical rough in and exterior masonry work are in progress for library addition. Structural Steel erection is underway for the Library addition. Painting in Cafeteria and Kitchen is nearly complete. Anticipated work to be performed over the next month includes the following:

  • Complete structural steel erection for Library addition.
  • Drywall work in Cafeteria to be completed.
  • Mechanical and Electrical Rough-in to be completed for Cafeteria

Update: 10-01-2016

The library addition and Cafeteria renovation is underway. Concrete walls have been completed. Underground rough in has been completed. Metal stud framing,  mechanical and electrical rough in and exterior masonry work are in progress. Anticipated work to be performed over the next month includes the following:

  • Complete footings for Library addition.
  • Masonry work and steel erection at Library addition to begin.
  • Drywall work in Cafeteria to begin.
  • Mechanical and Electrical Rough-in to be completed for Cafeteria

Update: 9-01-2016

The Technical Annex renovation is complete. The Band Parking lot is complete. The library addition is underway. Foundations are complete. Concrete walls have been completed along with waterproofing and backfill. Steel structure has been completed. The cafeteria/Kitchen renovation is underway.   Anticipated work to be performed over the next month includes the following:

  • Complete footings for Library addition.
  • Steel erection at Library addition to begin.
  • Drywall work in Cafeteria to begin.
  • Masonry work for Library addition to begin.

Update: 7-01-2016

The loop road is underway along with excavation for new utilities. Mechanical, electrical, and plumbing work is nearing completion in the Technical Annex renovation. Drywall is complete and painting is underway. Anticipated work to be performed over the next month includes the following:

  • Flooring in the technical annex.
  • Completion of the base course of the loop road.
  • Completion of the band parking lot.
  • Continued renovation of the vo-tech building.

Update: 6-01-2016

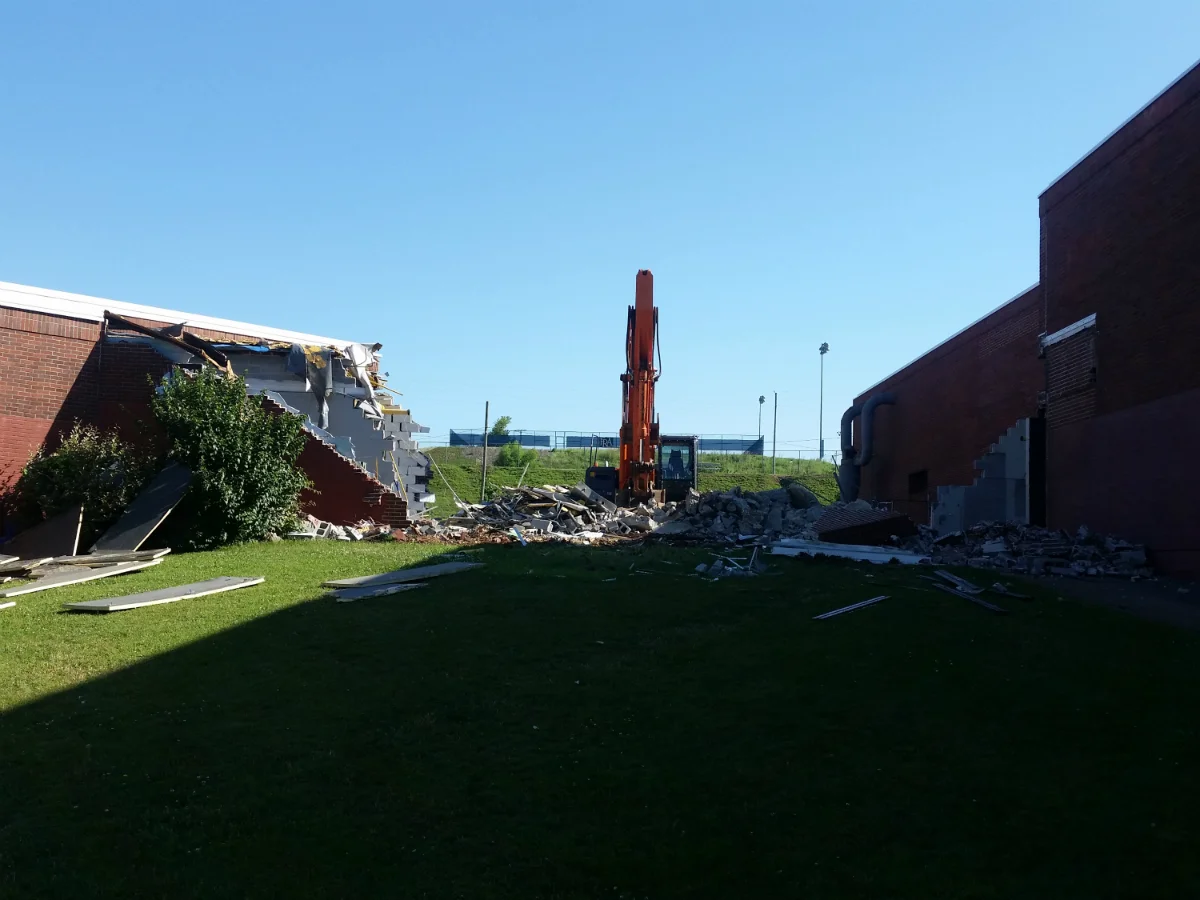

The contractor has mobilized to the site and demolition is underway. The TA has been totally gutted and the vo-tech building is nearly gutted. The connector between the two buildings is in the process of being removed. Anticipated work to be performed over the next month includes the following:

  • Stud Wall Framing in Technical Annex will be completed.
  • Stud Wall framing in the new cafeteria and kitchen will begin.
  • In wall and underslab rough-in will be completed in the Technical Annex
  • Drywall work will begin in the Technical Annex.
